Index of /internal/projects/901101_OceanImaging/Components/LidarWiSSL_Gen2/7 Detailed Design/1 Monthly Updates

[ICO]NameLast modifiedSizeDescription

[PARENTDIR]Parent Directory  -
[   ]20221228_WiSSL Gen2 Dec 2022_R1.pptx2022-12-28 14:56 37M
[   ]20221228_WiSSL Gen2 Dec 2022_R1.pptx.Notes.docx2022-12-29 07:45 27K
[   ]20230115_WiSSL Gen2 Jan 2023_R1.pdf2023-05-24 15:53 2.5M
[   ]20230422_WiSSL Gen2 Apr 2023_R1.pdf2023-05-24 15:53 1.9M

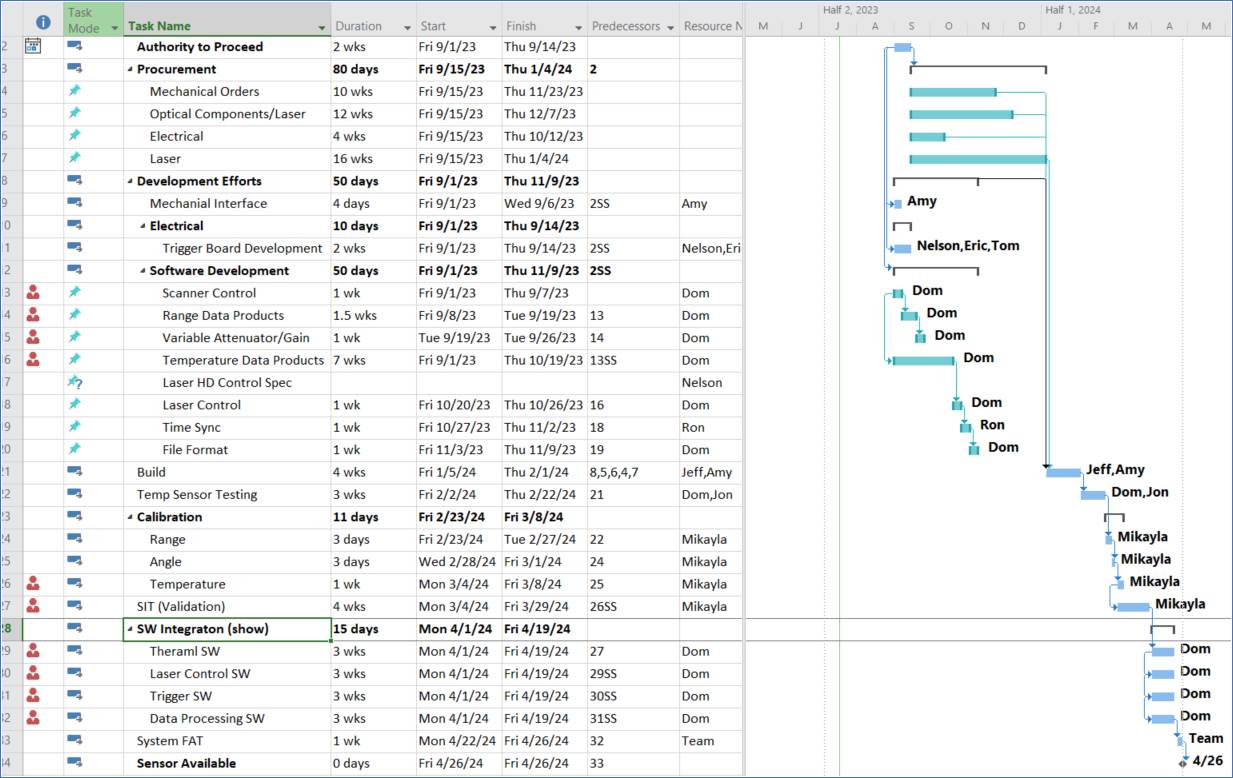

[IMG]20230608_MBARIStatudUpdate060823_GanttChart.jpg2023-07-21 09:22 137K
[   ]20230608_MBARIStatusUpdate060823.xlsx2023-06-08 10:22 25K
[   ]20230717_MBARIStatusUpdate071723.xlsx2023-07-18 14:50 26K
[   ]20231114_MBARIupdate111423.xlsx2024-02-29 14:17 21K

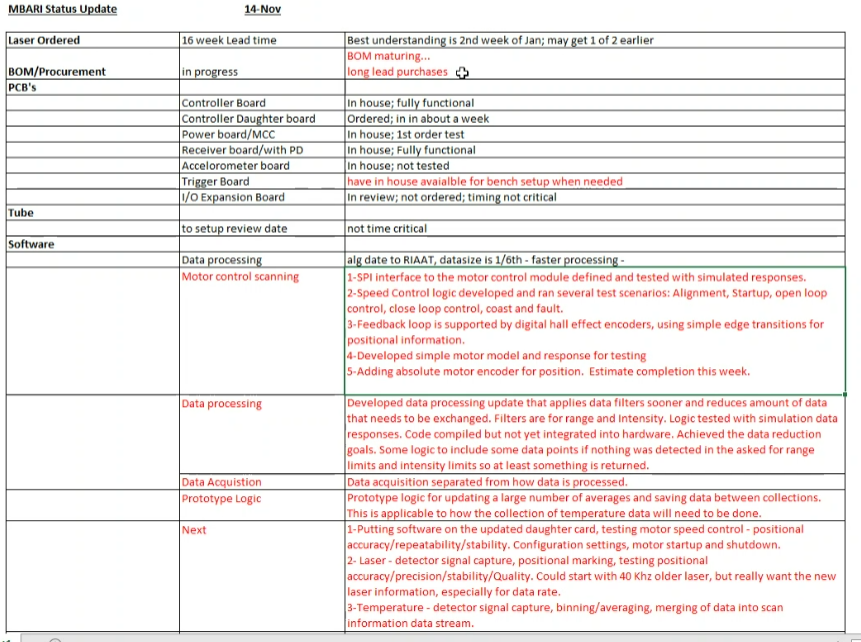

[IMG]20231114_statusUpdate.png2024-02-29 14:14 459K
[   ]20231219_MBARIupdate121923.xlsx2024-02-27 13:59 24K

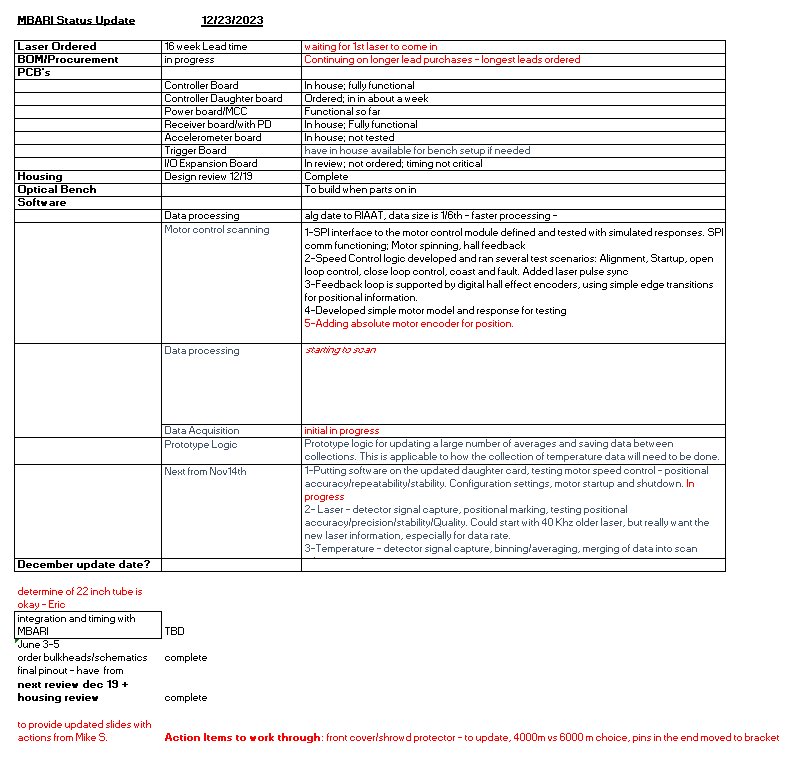

[IMG]20240123_statusUpdate.png2024-02-27 13:56 35K

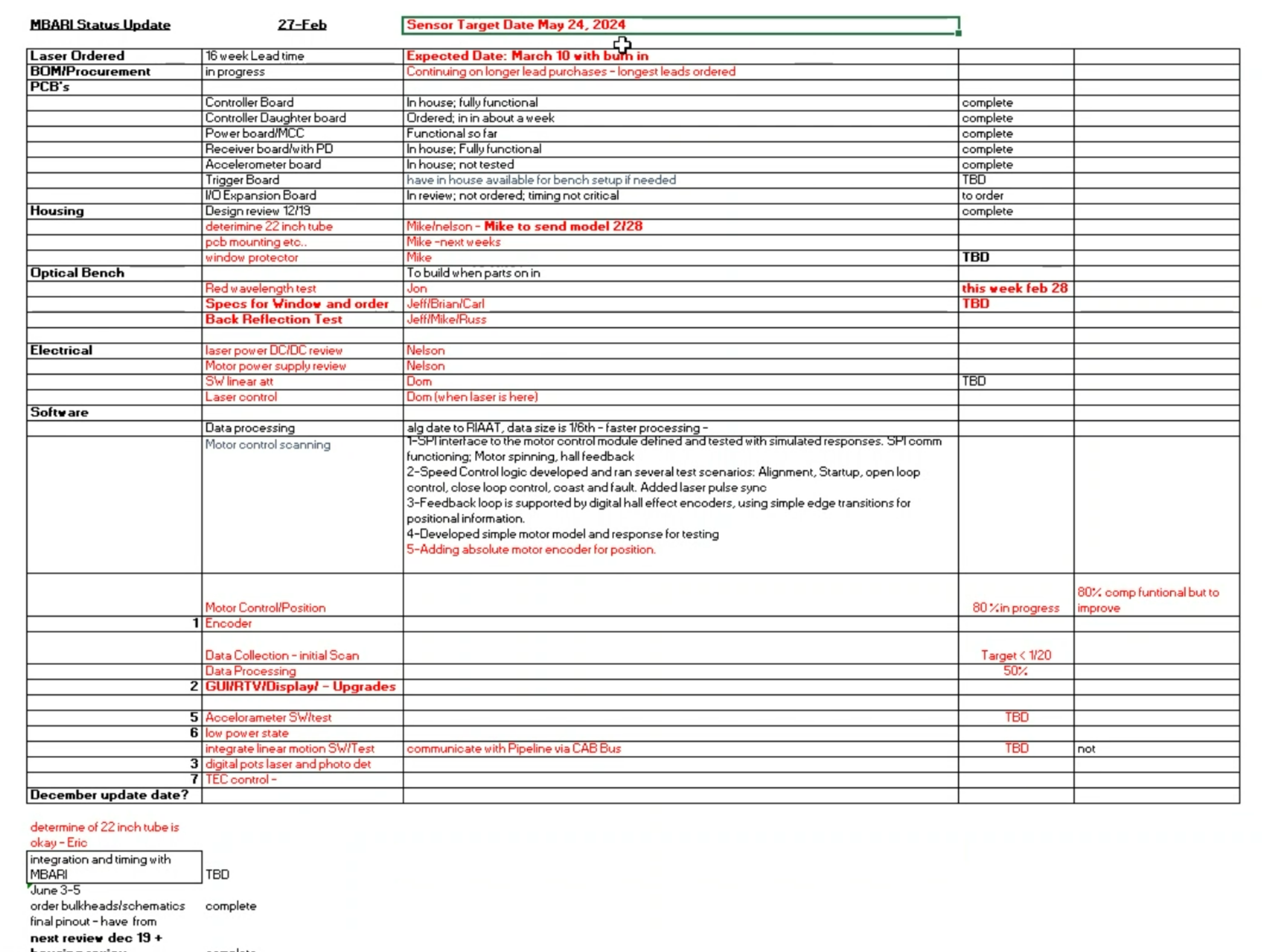

[IMG]20240227_StatusUpdate.png2024-02-27 13:57 1.5M
[   ]20240326_MBARIupdate032624.xlsx2024-03-26 15:34 316K
[   ]20240821_WiSSL Gen2 StatusUpdate08212024.pptx2024-08-25 20:24 18M
[   ]20240918_WiSSL Gen2 StatusUpdate08212024.pptx2024-09-18 15:08 18M

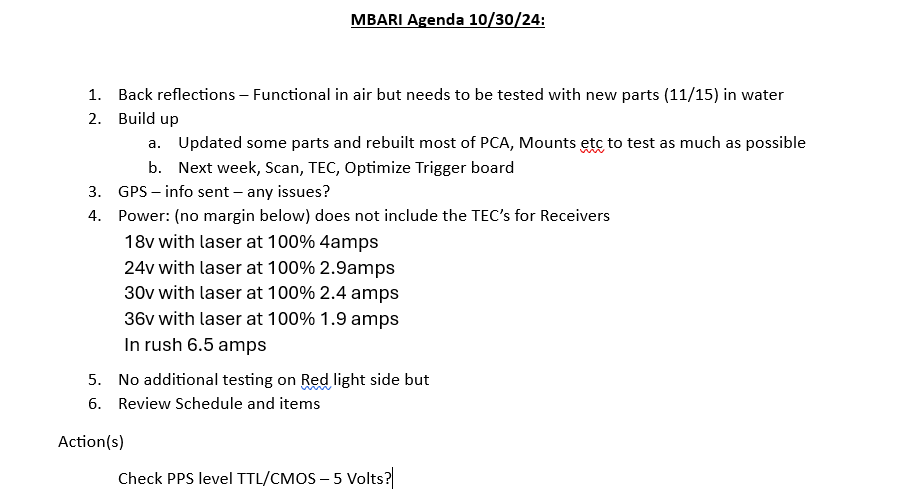

[IMG]20241030_Agenda.png2025-03-30 12:00 39K
[   ]20241030_MBARI103024.pdf2024-11-25 02:00 289K
[   ]20250225_MBARIStatus022525.xlsx2025-03-30 11:58 58K
[   ]20250319_WiSSLupdate031925.pptx2025-03-30 11:57 19M
